Get in touch
Future-Facing Minerals

Carrapateena Mine Underground Crusher 1.0


Client
BHP (formerly OZ Minerals)
Duration
May 2019 - Apr 2020
Location
Pernatty , South Australia, Australia
Value
$17 million

PHE Group’s inaugural underground crusher delivery at Carrapateena set the pace – completing a technically complex install five weeks ahead of schedule through deep collaboration, decisive management, and a strong safety culture.

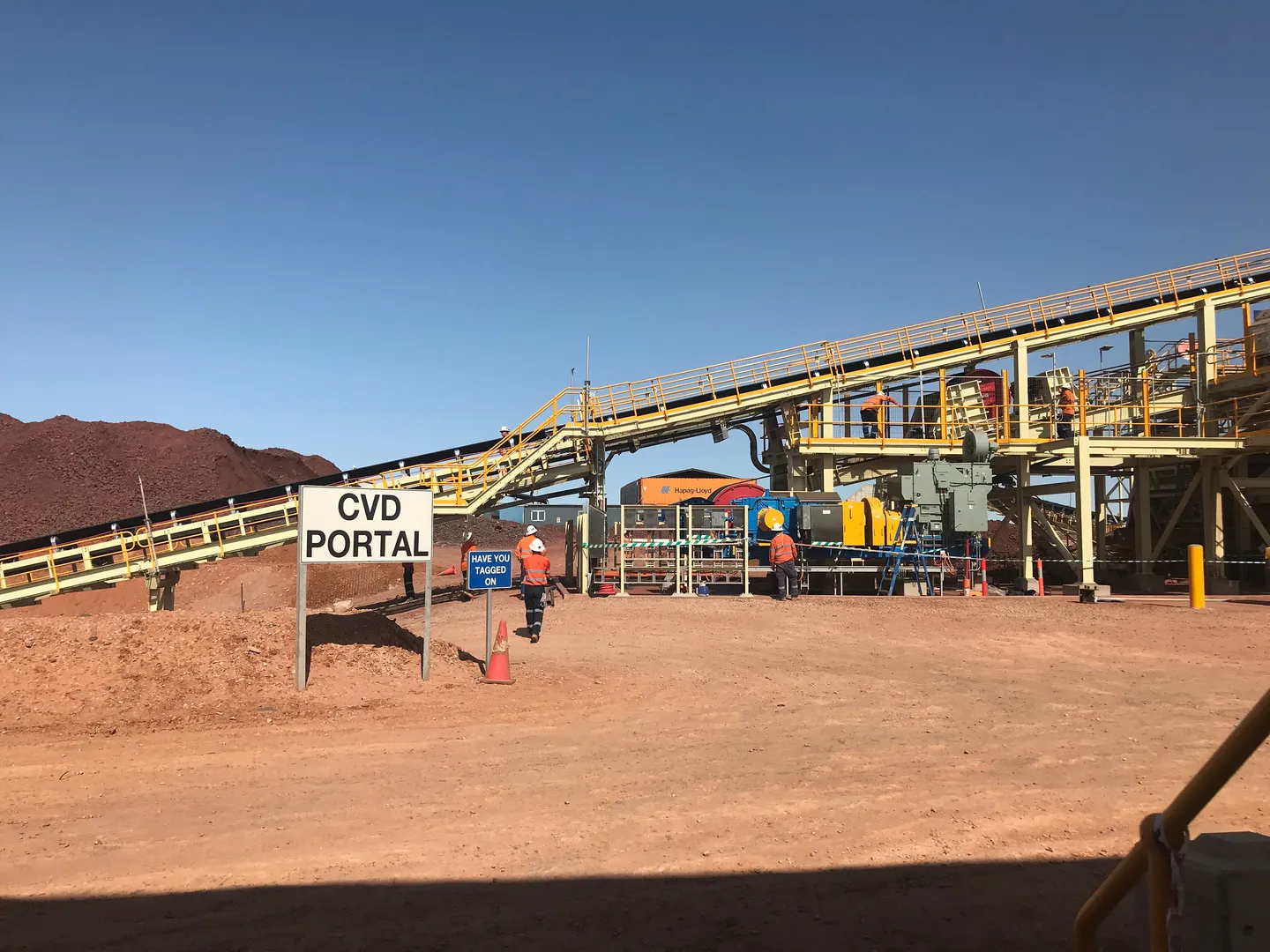

As the first underground infrastructure package, the project enabled 4.3Mtpa ore throughput via a 3 kilometre inclined conveying system to surface, significantly reducing reliance on traditional haulage methods.

Delivered within a live mine environment, the works were staged through confined tunnels and ventilation-reliant spaces with active haulage and fixed plant operations nearby. Tight access, limited laydown, and concurrent contractor activity demanded rigorous interface control, adaptive scheduling, and round-the-clock coordination. PHE was engaged to deliver the full electrical and instrumentation package, drawing on deep site familiarity and a proven record of performance in high-risk environments.

Project scope

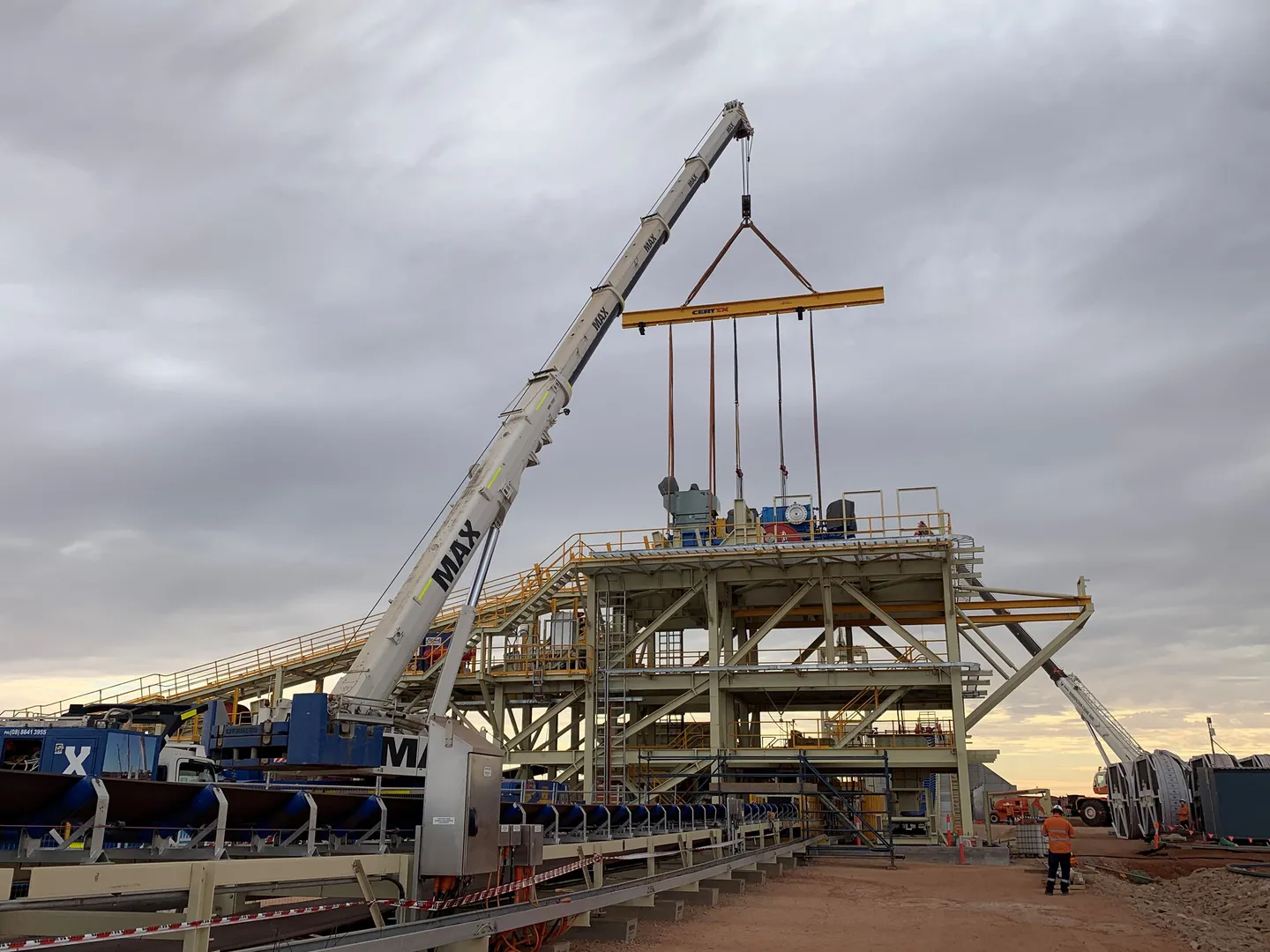

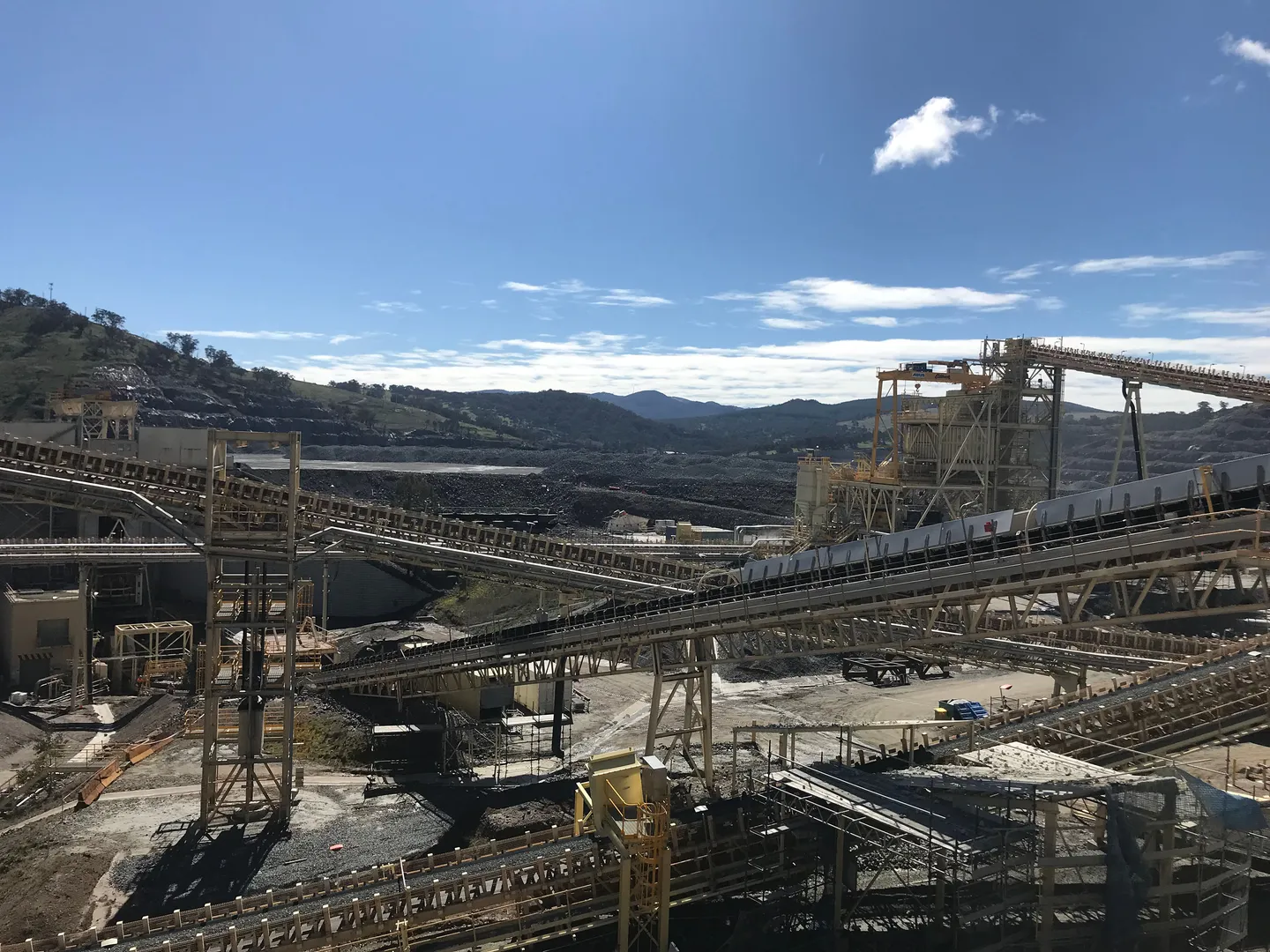

  • Electrical and instrumentation (E&I) works delivered across the primary crusher, ore handling conveyors, and associated infrastructure.

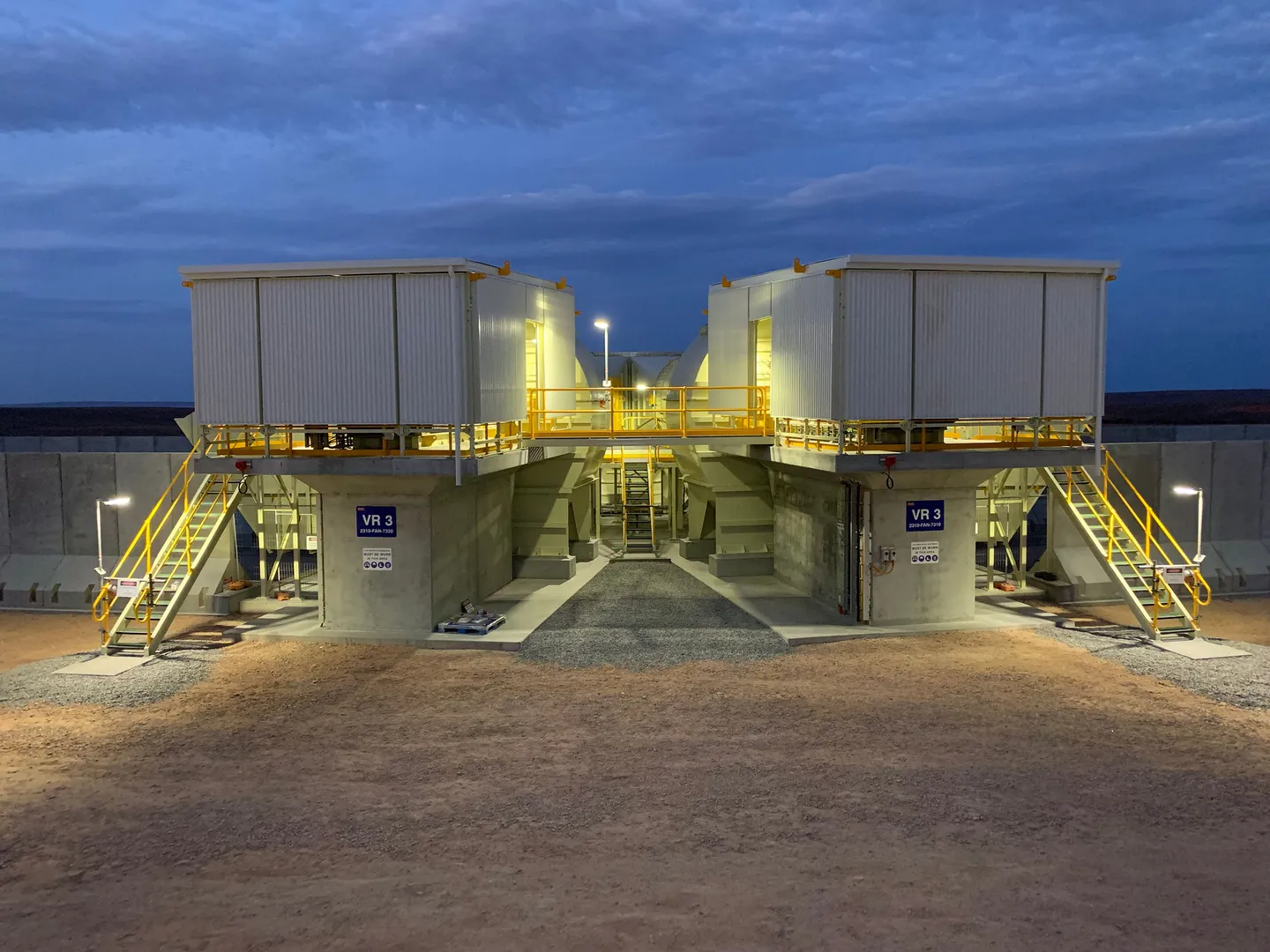

  • Commissioning of 11kV distribution system, dewatering infrastructure, and primary ventilation systems.
  • Integration of all E&I works with civil and SMP teams through a collaborative delivery model.

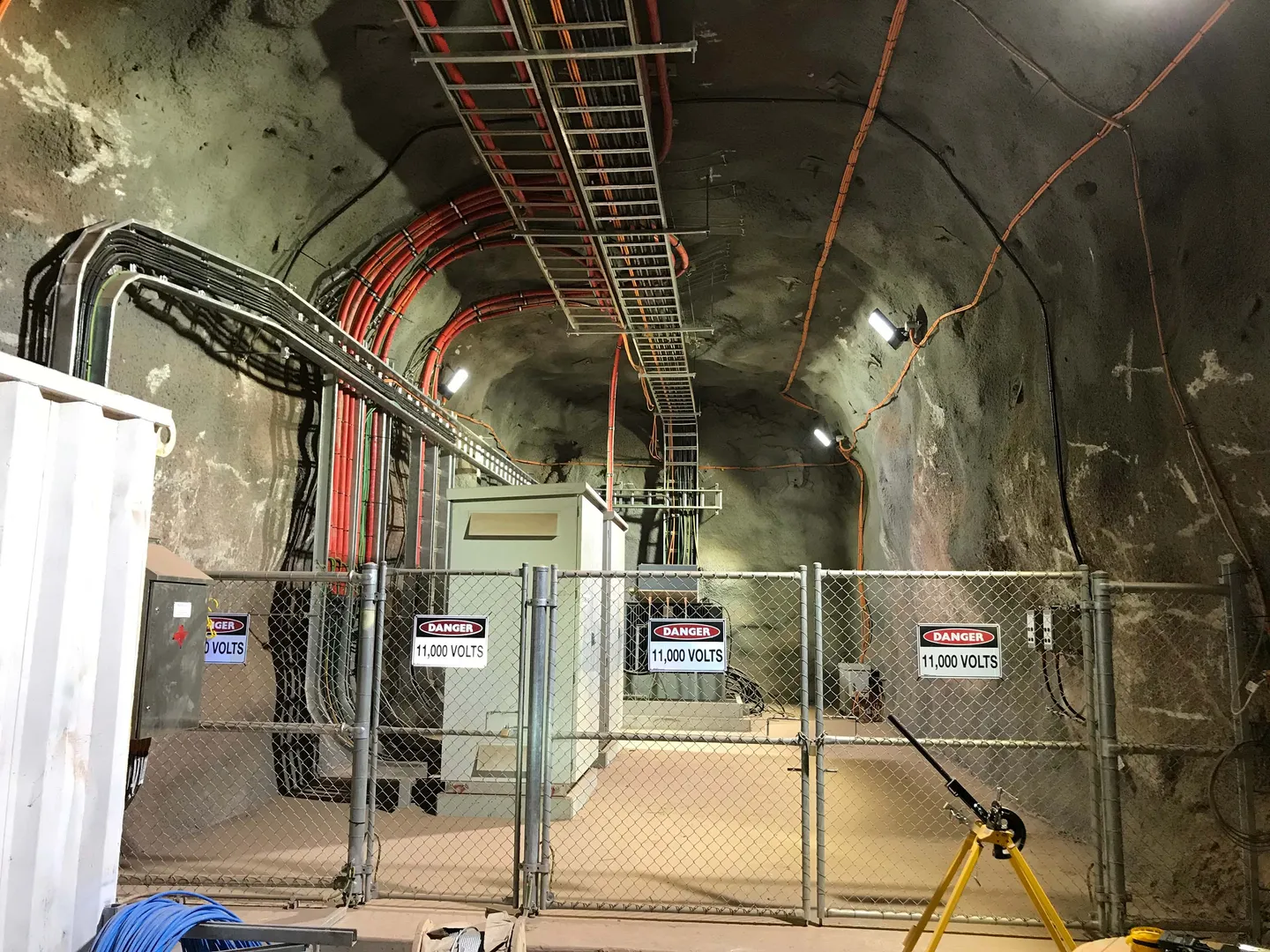

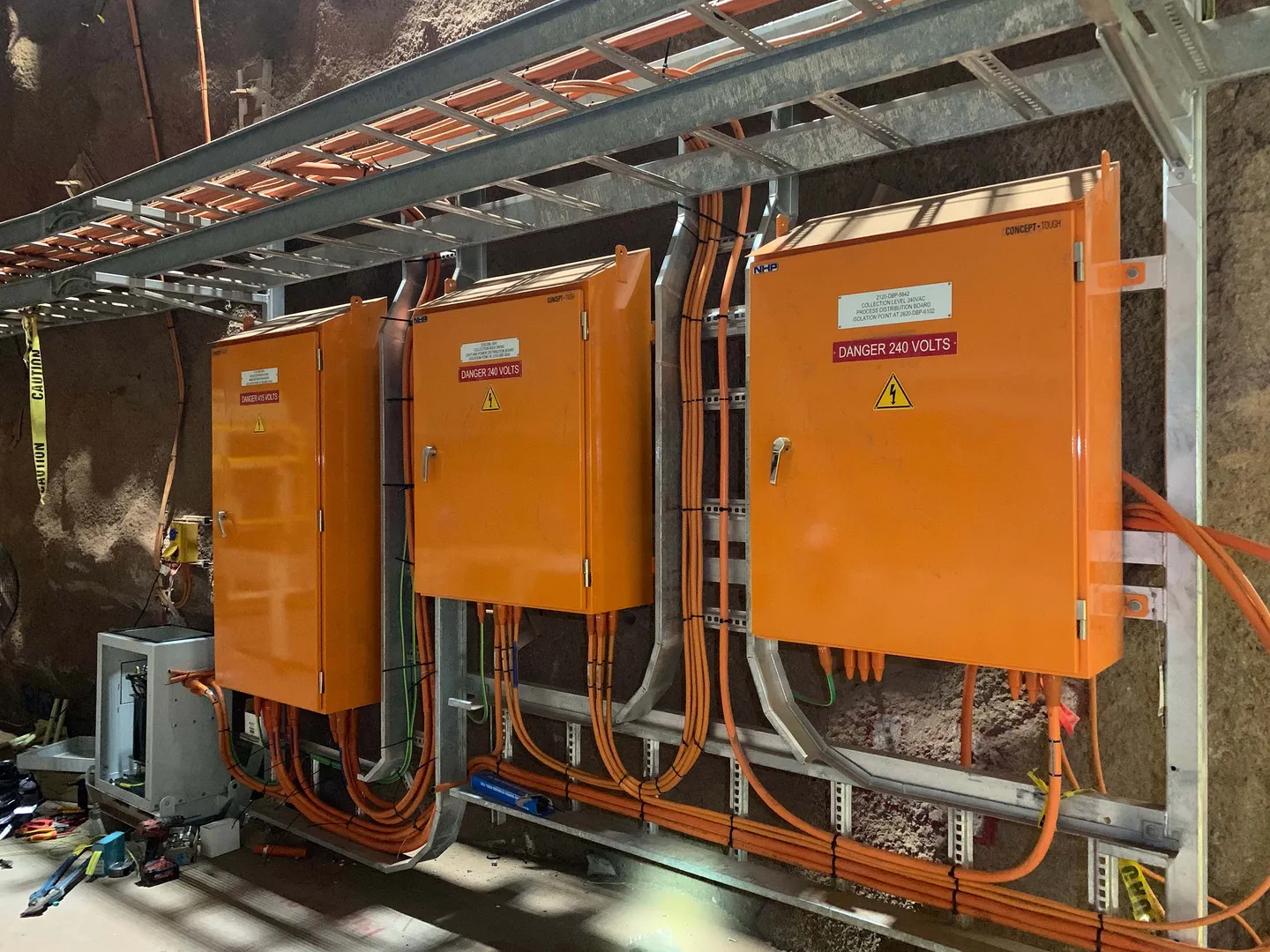

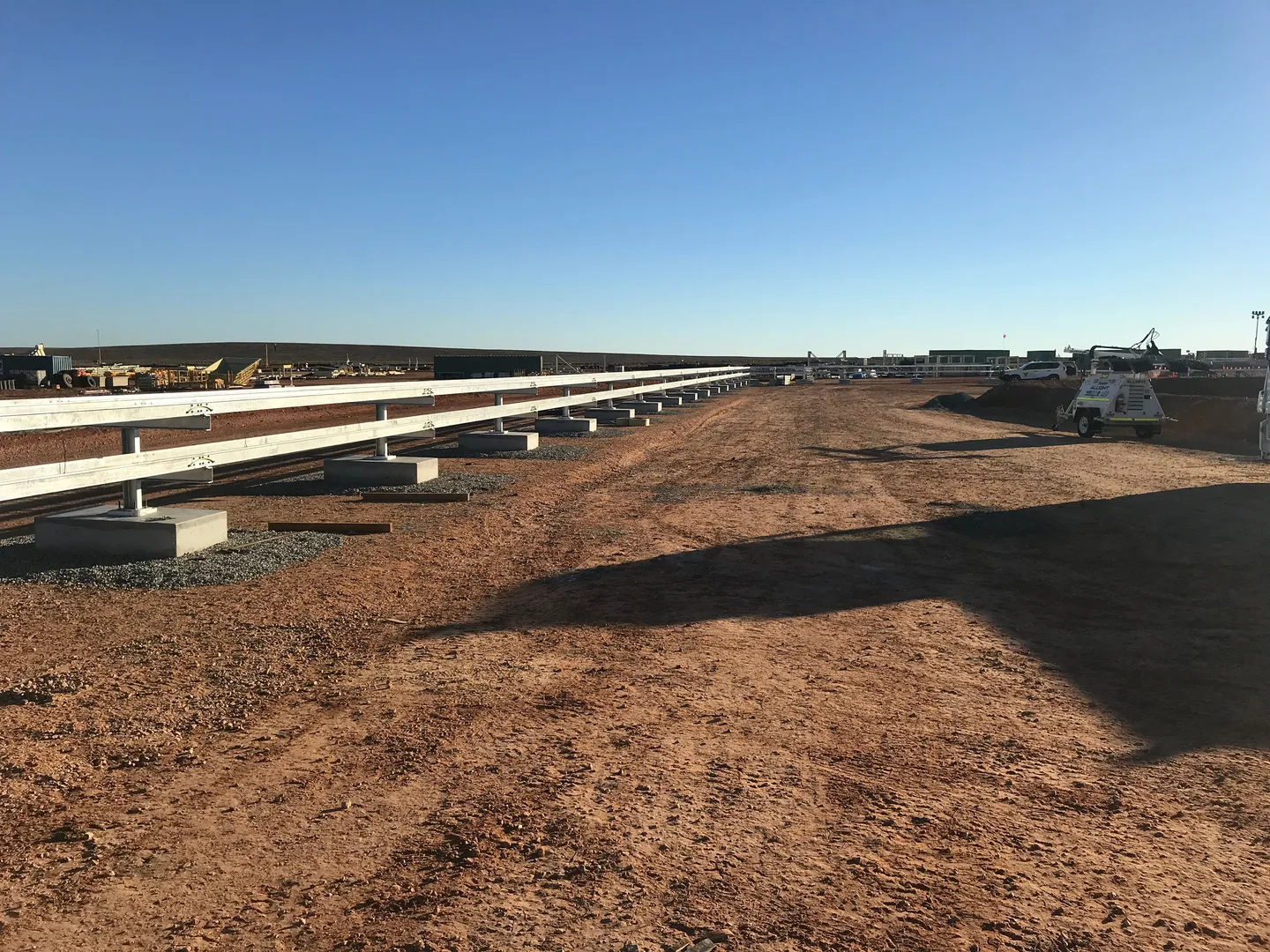

  • Installation of high voltage, low voltage, communication, and instrumentation cabling underground and to surface.
  • Construction of a temporary 24-bed self-sufficient camp to address on-site accommodation constraints.

Innovations and solutions

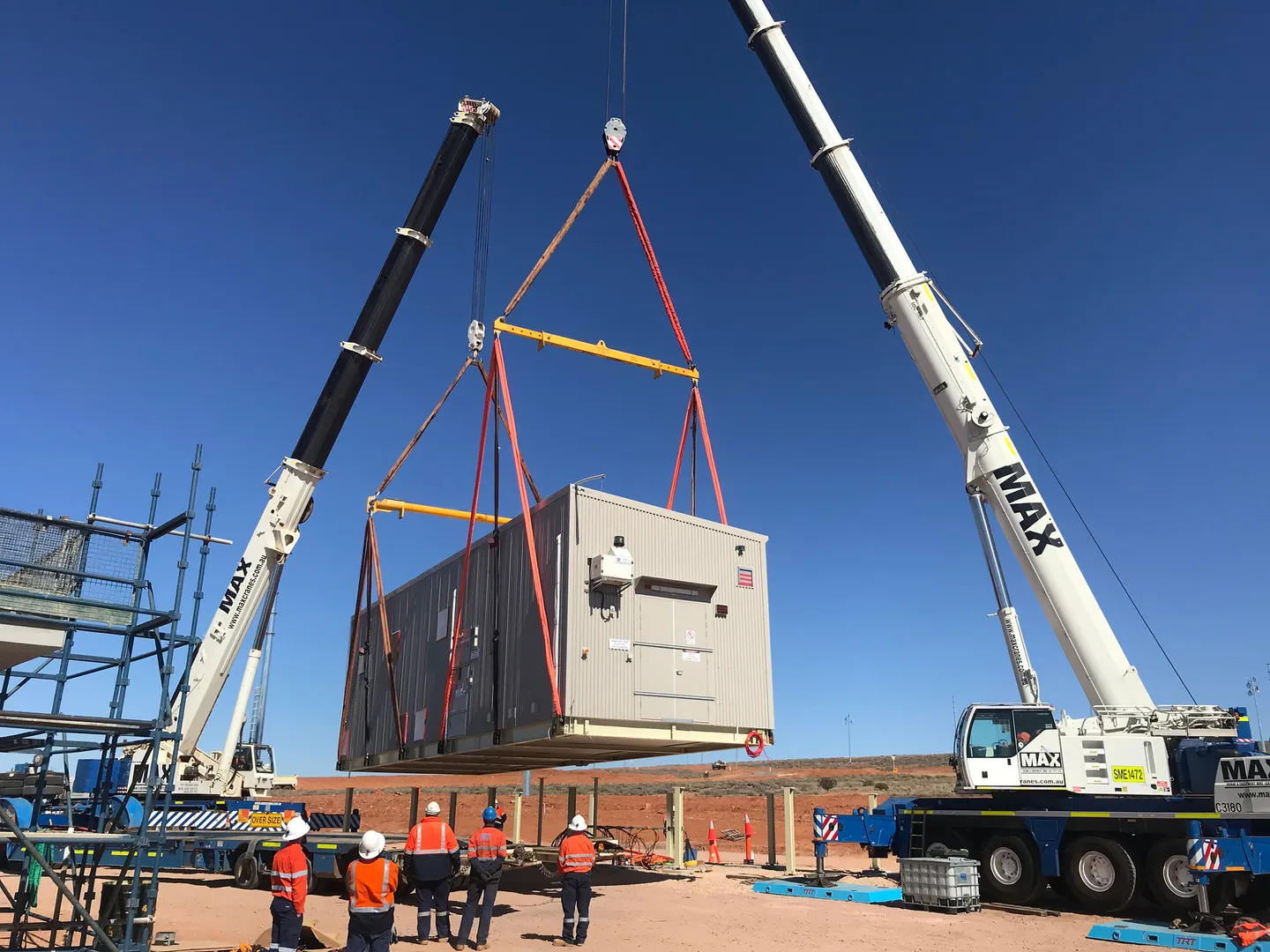

  • Early Contractor Involvement (ECI) allowed for cost forecasting, FAT testing, and smoother site mobilisation.
  • A bespoke cable reeler was designed and fabricated to enable safe HV cable installation in confined underground spaces.
  • LED strip lighting was used to reduce power demand and accelerate temporary lighting installation.
  • Battery-powered tooling was deployed site-wide – reducing reliance on 240V equipment and significantly lowering electrical risk in wet conditions.
  • A temporary camp was designed, mobilised, and commissioned within one week to prevent schedule delays.
  • Underground HV/Earth cable installation in boreholes was backed by engineered calculations and hold-point methodology.

Outcomes and benefits

  • Delivered five weeks ahead of schedule and under budget, protecting operational timelines and unlocking early production gains.
  • QA admin time reduced by 25% using the PIMS system which improved traceability and streamlining energisation processes.
  • Zero lost-time injuries recorded across approximately 150,000 hours worked, reflecting a deeply embedded safety culture.
  • Strengthened PHE Group’s relationship with BHP, directly contributing to the award of the Crusher 2.0 contract.
  • First ore achieved two months early – despite bushfire-related delays – through disciplined planning and site coordination.
  • Scope growth of more than 32,000 hours absorbed without delaying commissioning, demonstrating agility under pressure.
  • HV terminations provided high-value training and certification opportunities for internal personnel, building capability and retention.
  • This first major milestone laid the foundation for long-term productivity at one of Australia’s most important copper-gold assets – a critical contributor to BHP’s future-facing investment in clean energy supply chains.
Accelerated ore production
2 months
Extra hours managed on program
32K+
Injury-free hours worked
150K+

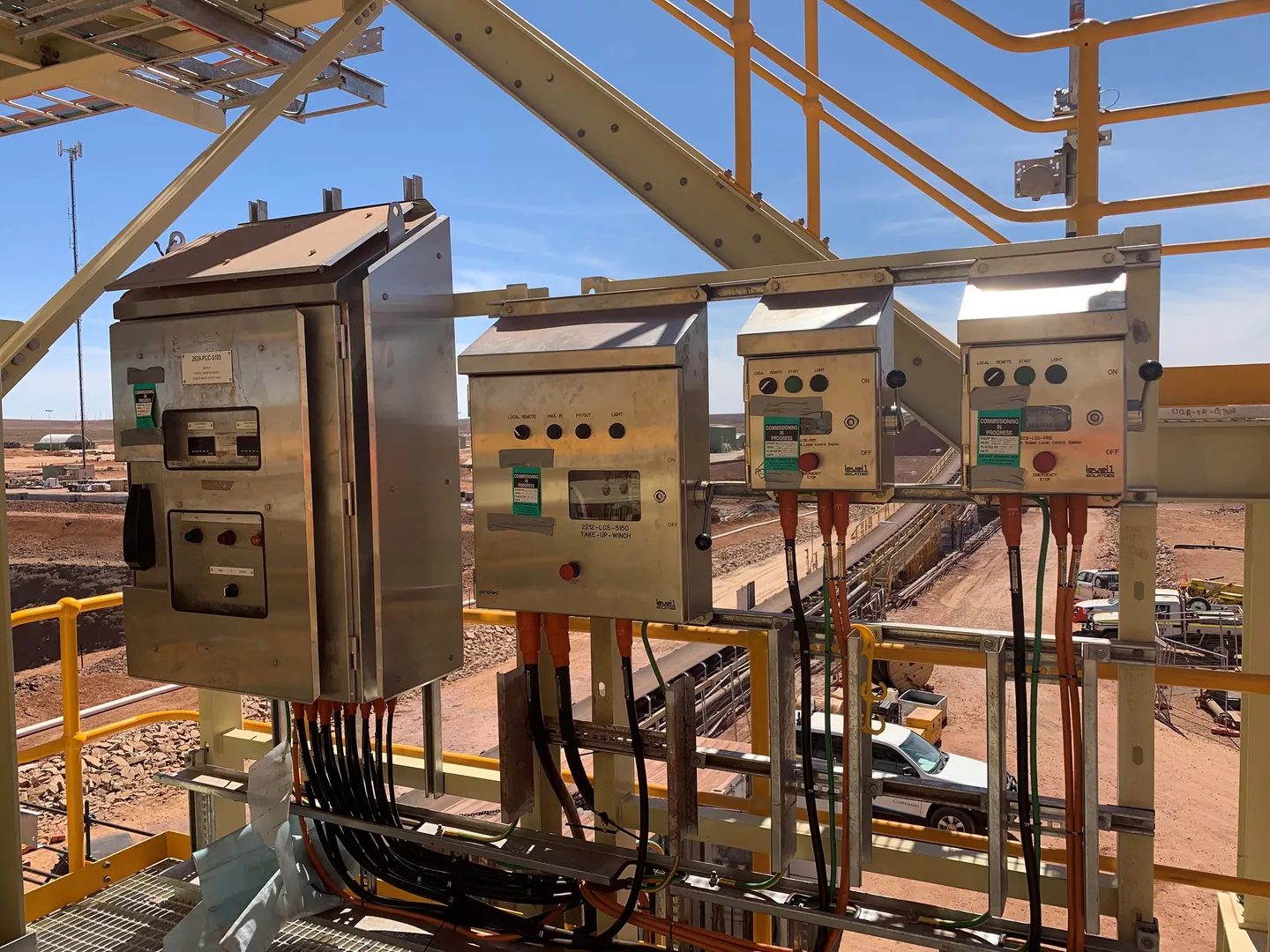

Project Images
